Ramsey Gateway Project

Ramsey Gateway Highway 10 Project Banner



Welcome to the project website for the Ramsey Gateway Highway 10 Project.  This website provides an overview of the project, houses the public meeting summaries, and will contain updates as the project evolves. Detailed information that is shared at the public meetings, such as design alternates, videos, or interactive maps, are housed on the virtual open house webpage .

Email Updates

To sign up for updates or to access your subscriber preferences, please enter your contact information below:


 Email Updates
To sign up for updates or to access your subscriber preferences, please enter your contact information below.


Project Updates

Watch a fly-through video of the final design:

Paving work begins Monday, July 24 in preparation for upcoming Ramsey Gateway Construction

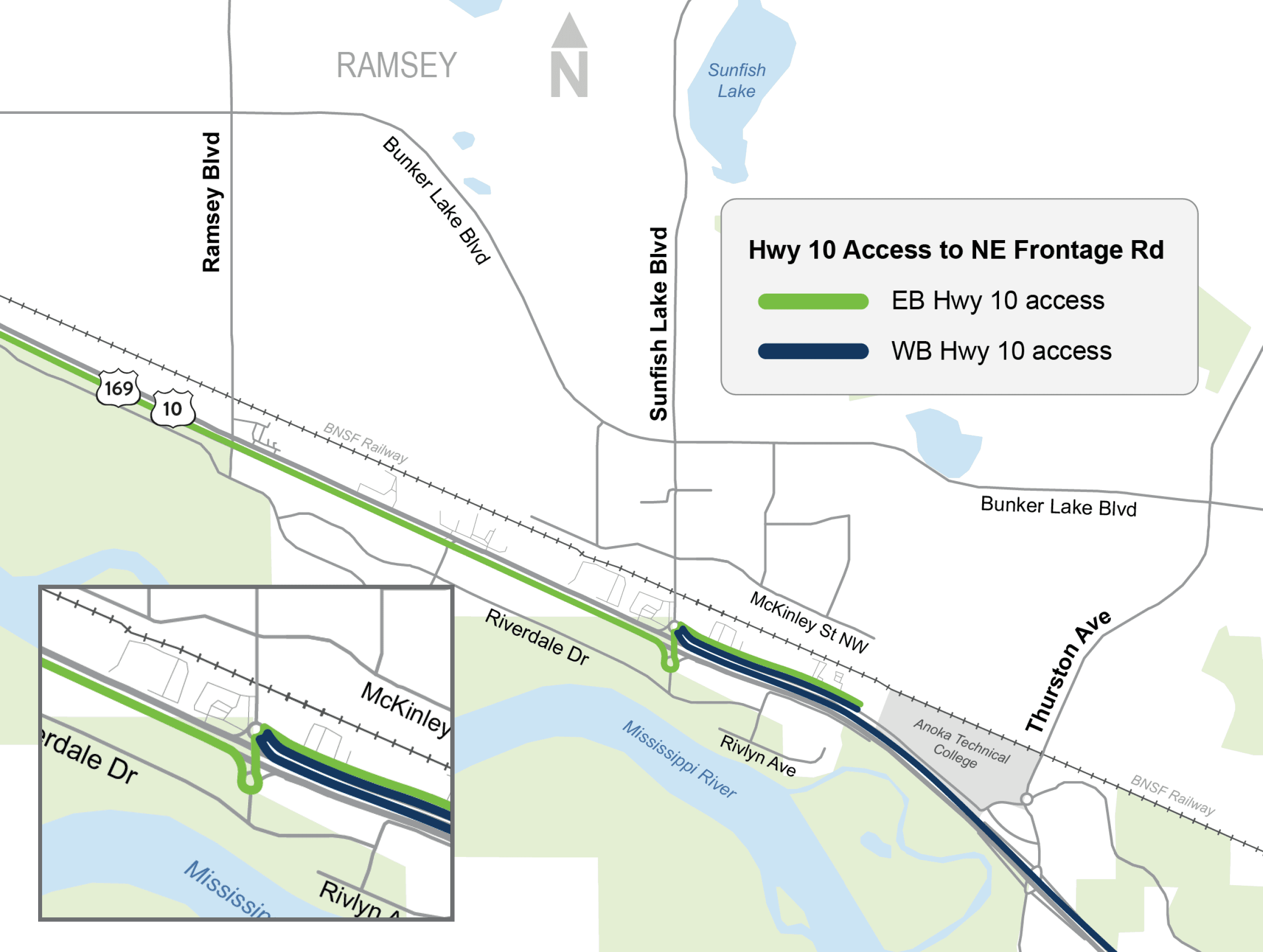

Beginning on Monday, July 24, westbound Highway 10 between sunfish Lake Boulevard and Armstrong Boulevard will be reduced to a single lane of traffic while crews widen the highway in preparation for the Ramsey gateway construction project.

The westbound Highway 10 lane closure will remain in place through Fall 2023. Eastbound Highway 10 is expected to remain open to two lanes of traffic during the work.

Paving the highway and widening the lanes this year will allow for two lanes of traffic to remain open during the 2024 and 2025 construction seasons.


Project Description

Anoka County, MnDOT, and the City of Ramsey developed a locally supported vision of the Highway 10 corridor through Ramsey as part of the Ramsey Gateway Highway 10 Study. The Ramsey Gateway Highway 10 Project continues that vision with design of two grade-separated interchanges at Ramsey Boulevard and Sunfish Lake Boulevard that will replace existing signalized intersections. Grade separation of the BNSF Railway and a new frontage road between Ramsey Boulevard and Sunfish Lake Boulevard are also part of this design project.

Project goals include:

  • Safely accommodating all users including motor vehicles, freight, rail, transit, pedestrians, and bicyclists
  • Providing efficient mobility and access for all modes of travel
  • Developing a financially responsible design that minimizes right-of-way and environmental resource impacts
  • Securing additional funding for full project construction

We are currently in final design in preparation for construction activities to begin in 2023. For an overview of the project development process, see the graphic below.

Process


Schedule

Key milestones of the project are shown in the schedule below:

  • Public Open Houses – Winter 2021, Spring 2021, Summer 2022, Early Spring 2023
  • Preliminary Design – June 2020 to August 2021
  • Final Design – September 2021 to Jan 2023
  • Right of Way Acquisition Process – January 2022 to January 2023
  • Preliminary Construction Activities (Widening): Summer/Fall 2023
  • Primary Construction: Spring 2024 – Fall 2025

CSAH 56-57 Schedule 01-21-2022
